Dundas Street East, Paris Road, and Oak Park Road, Paris

Share Dundas Street East, Paris Road, and Oak Park Road, Paris on Facebook Share Dundas Street East, Paris Road, and Oak Park Road, Paris on Twitter Share Dundas Street East, Paris Road, and Oak Park Road, Paris on Linkedin Email Dundas Street East, Paris Road, and Oak Park Road, Paris link

The County of Brant is reconstructing Dundas Street East, Paris Road, and Oak Park Road. With work beginning in 2025, this multi year infrastructure project is replacing aging underground services and will improve how the road functions for drivers, pedestrians, businesses, and future employment growth in the area.

Work will take place along the following sections.

  • Dundas Street East between Curtis Avenue and the intersection of Dundas Street East and Paris Road, plus about 150 metres on Governors Road
  • Paris Road from Dundas Street East south to the intersection of Paris Road and Oak Park Road
  • Oak Park Road from

The County of Brant is reconstructing Dundas Street East, Paris Road, and Oak Park Road. With work beginning in 2025, this multi year infrastructure project is replacing aging underground services and will improve how the road functions for drivers, pedestrians, businesses, and future employment growth in the area.

Work will take place along the following sections.

  • Dundas Street East between Curtis Avenue and the intersection of Dundas Street East and Paris Road, plus about 150 metres on Governors Road
  • Paris Road from Dundas Street East south to the intersection of Paris Road and Oak Park Road
  • Oak Park Road from Paris Road to the railway tracks

A future roundabout is planned for the Paris Road and Oak Park Road intersection. Construction for that feature is expected in 2028.

What to expect

This project focuses on full road reconstruction and major underground servicing including:

  • New watermain, sanitary sewer, and storm sewer on Dundas Street East
  • New watermain and sanitary sewer on Governors Road
  • New watermain and sanitary sewer on a portion of Paris Road
  • A low pressure sanitary forcemain from Paris Road to Oak Park Road and south to the railway tracks
  • Road resurfacing with new curbs and sidewalks in urban areas
  • Dual left turn lanes on Paris Road from the water tower to Oak Park Road

Traffic impacts

Delays are expected during construction.

  • Dundas Street East will be reduced to two (2) lanes during daily construction activities and may be reduced to one (1) lane from time to time.
  • Governors Road will be reduced to one lane for approximately 150 metres.
  • Paris Road and Oak Park Road will be reduced to one lane during daytime construction. Staff are working with the contractor on when and where two-way traffic in the evenings and on weekends may be possible. Expect delays.

Important reminders

Access to properties, businesses, and emergency services will be maintained during construction.

Please refer to Municipal 511 for the most up-to-date traffic information regarding road construction and closures.

The timeline provided on this page outlines the necessary updates in the order they will occur.

Stay informed

Progress and major milestones will be posted on this page. Subscribe for updates about this project by adding your email to the Stay Informed box on this page and click ‘Subscribe'.

  • Dundas Street East construction expected to begin end of March

    Share Dundas Street East construction expected to begin end of March on Facebook Share Dundas Street East construction expected to begin end of March on Twitter Share Dundas Street East construction expected to begin end of March on Linkedin Email Dundas Street East construction expected to begin end of March link

    Road reconstruction for Dundas Street East, Paris Road and Oak Park Road is beginning shortly.

    This multi-year infrastructure project is replacing aging underground services, extending new services and will improve how the road functions for drivers, pedestrians, businesses, and support future employment growth in the area – bringing new jobs close to home.

    Work is expected to start in late March 2026.

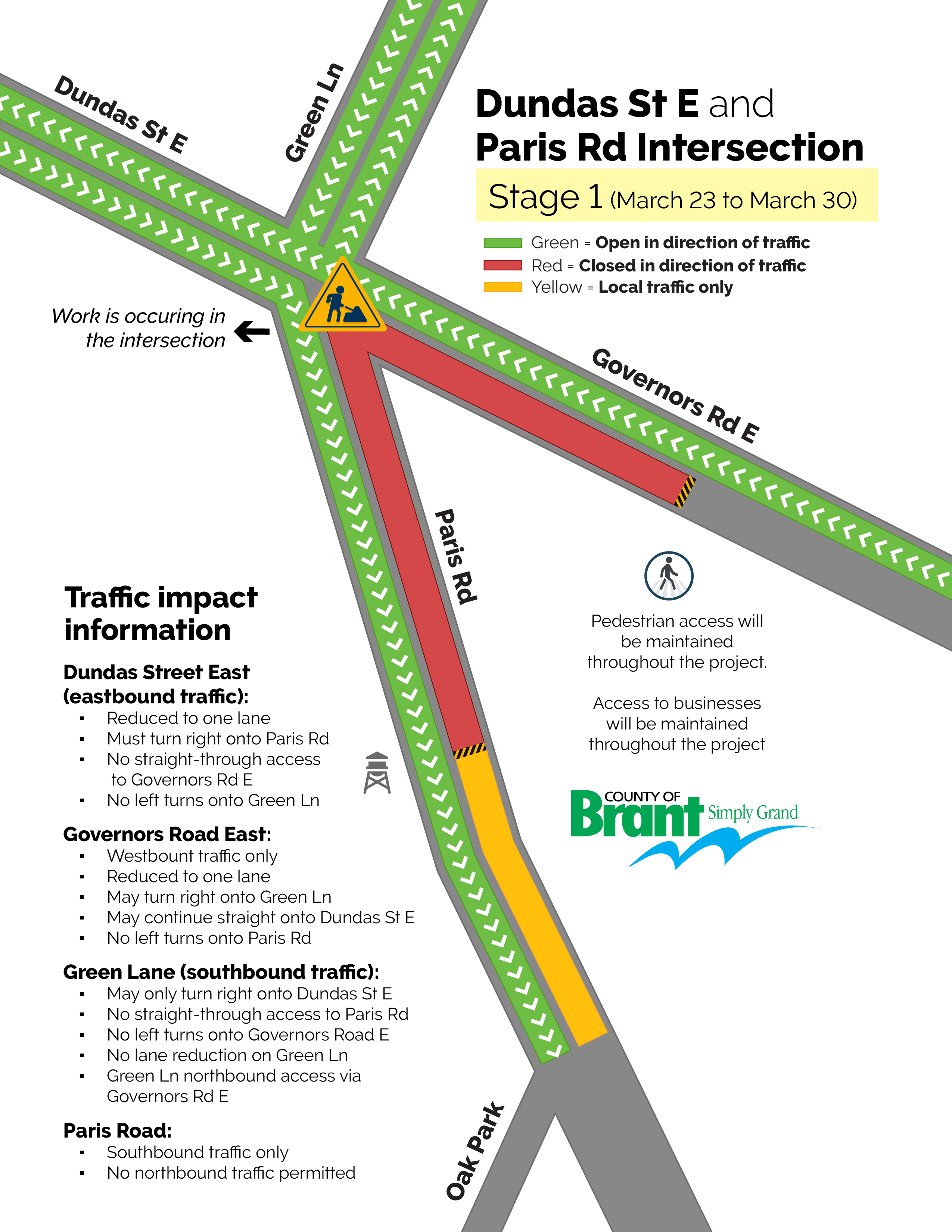

    Stage 1 (Anticipated March 23 - 30, 2026)

    Dundas and Paris Road Intersection

    • Complete installation of sanitary, storm sewers and watermain within the intersection to the south and east.


    Traffic Impacts

    • Dundas St E - Eastbound traffic will be reduced to one lane which must detour onto Paris Rd. There will be no straight through onto Governors Rd E or left turns onto Green Ln at the intersection.
    • Dundas St E - Westbound traffic will be maintained.
    • Governors Rd E - Westbound traffic will be reduced to one lane. Left turns onto Paris Rd will not be permitted.
    • Green Lane - Southbound traffic may only turn right onto Dundas St E. There will be no straight through onto Paris Rd or left turns onto Governors Rd E
    • Paris Rd - Only southbound traffic permitted

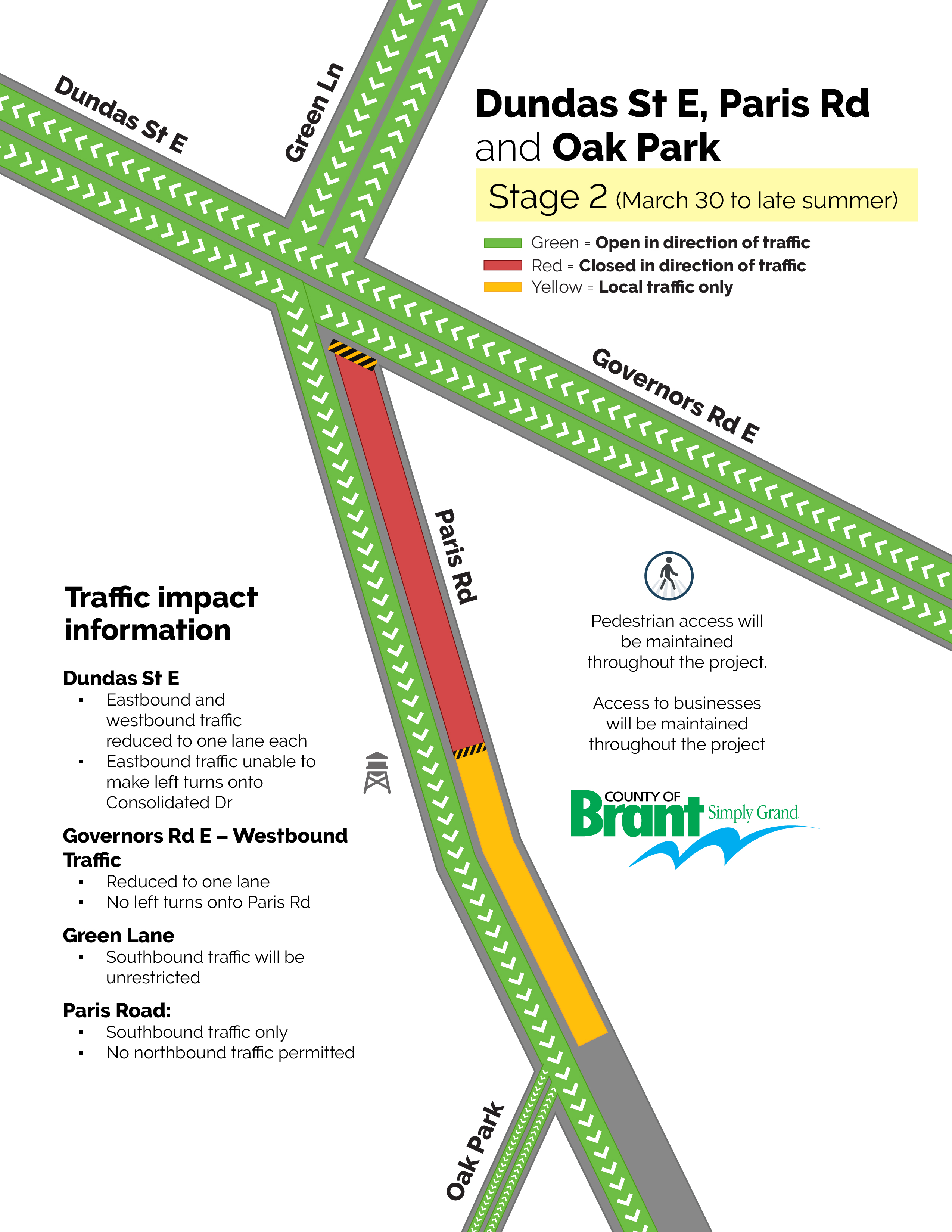

    Stage 2 (Anticipated March 30, 2026 to late Summer)

    Dundas Street East (both eastbound lanes on the south side of the road) and Paris Road

    • Dundas St E - Complete the tunneling for the watermain under the CN bridge
    • Dundas St E (between Curtis Ave S to Paris Rd on the south side of the road) - Complete installation of watermain and services
    • Dundas St / Paris Rd intersection - Relocate hydro poles
    • Dundas St E (two south lanes) - Complete the road restoration, curbing and sidewalk
    • Paris Rd - Complete installation of sanitary, storm sewers, watermain
    • Paris Rd to Oak Park Rd and on Oak Park Rd to the railway tracks - Complete installation of sanitary forcemain
    • Paris Rd - Complete road restoration, curbing and some sidewalk


    Traffic Impacts

    • Dundas St E – Eastbound and westbound traffic will be reduced to one lane each Eastbound traffic will be unable to make left turns onto Consolidated Dr
    • Governors Rd E - Westbound traffic will be reduced to one lane and unable to make left turns onto Paris Rd
    • Green Lane - Southbound traffic will be unimpeded
    • Paris Rd – There will only be southbound traffic. No northbound traffic permitted




    Stage 3 is scheduled to occur between late Summer to late Fall and will focus on Dundas Street (both westbound lanes on the north side of the road) and Governors Road. Traffic impacts will occur and will be communicated prior to the start of this stage.

    • Pedestrian access will be maintained throughout the project.
    • Access to businesses will be maintained throughout the project.

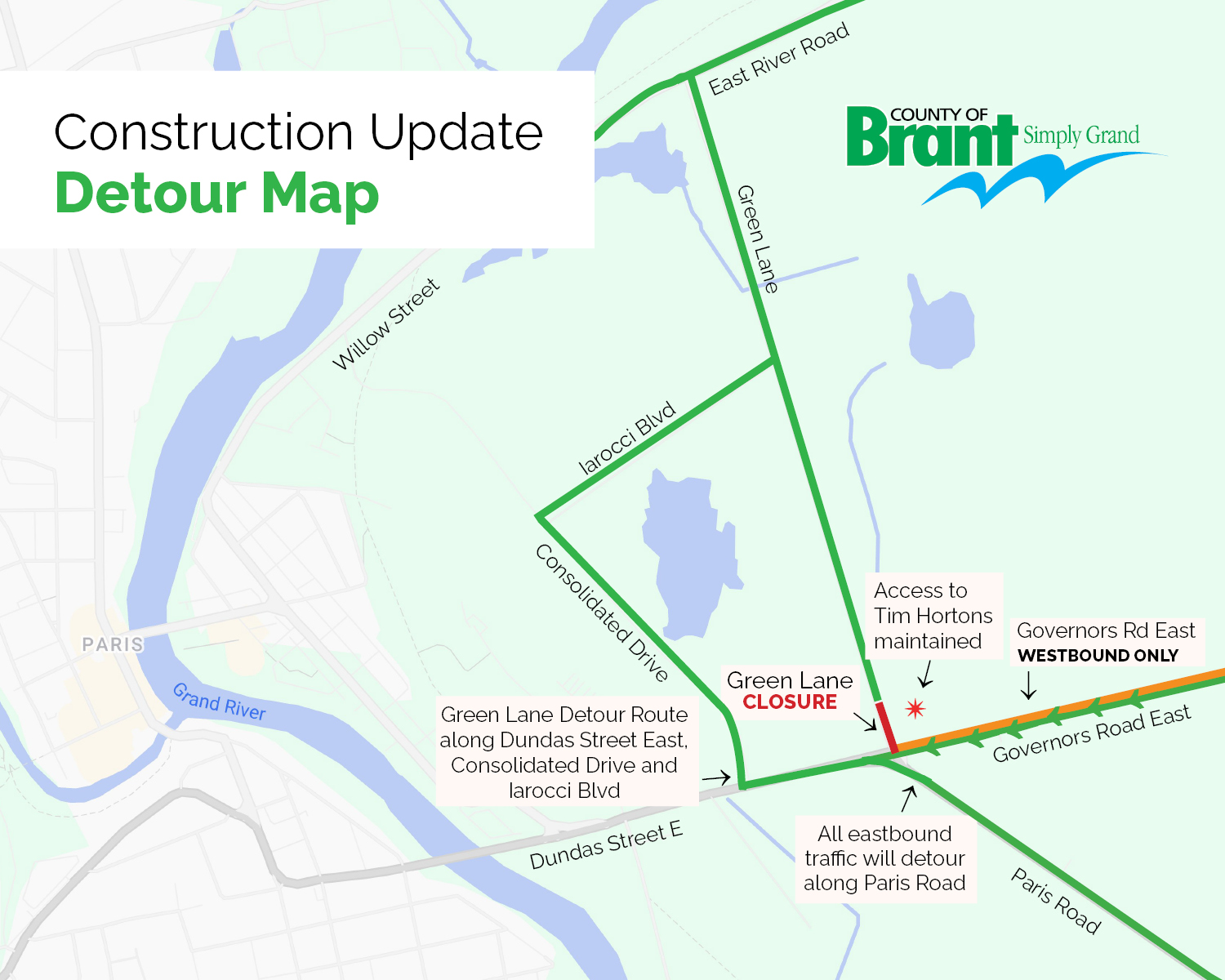

    • Detours will be posted. This closure will impact travel through the east end of Paris and will require detours for traffic travelling to and from the east end of the community.


    For the most up-to-date information about the project, please subscribe for updates by adding your email to the Stay Informed box on this page and click ‘Subscribe'.

    For road construction updates and closure information, please refer to Municipal511.

    It is our goal to minimize any inconvenience to our residents. Your patience through any disruption will be greatly appreciated.

    Share your questions or comments directly with the project team.

    If additional information is required, please contact operations@brant.ca.

  • Project update: February 2026

    Share Project update: February 2026 on Facebook Share Project update: February 2026 on Twitter Share Project update: February 2026 on Linkedin Email Project update: February 2026 link

    Construction is continuing on the Dundas Street East, Paris Road, and Oak Park Road reconstruction project. This work replaces aging underground infrastructure and prepares the area for future growth.

    Where we are and where we're going

    Through summer 2025 work has progressed on Dundas Street East and Governors Road, including major underground servicing. Some delays have occurred due to site conditions and project complexity.

    Construction will begin again 2026 and continue through 2027 as work moves along Paris Road and Oak Park Road. Road resurfacing, new curbs, sidewalks, and lane improvements will follow underground servicing.

    What to expect this spring

    As construction begins again in the spring, lane reductions will continue during daytime construction, with two way traffic in the evenings and on weekends. Expect delays and plan extra travel time. Access to homes and businesses will also be maintained throughout construction with clear signage and detour routes available.

    Stay informed

    Construction will continue in phases. More information and updates will be shared on this page as they are available and projects subscribers will be notified directly, through email.

    We invite you to subscribe for updates by adding your email to the Stay Informed box on this page and click ‘Subscribe'.


Page last updated: 06 Mar 2026, 02:27 PM
