East Flats, Paris
The County of Brant is planning road reconstruction work in the East Flats neighbourhood in Paris. This multi-year project will take place in 2 phases and will replace aging underground infrastructure and improve local roads.
The work will help ensure safe, reliable water service, improve stormwater management, and extend the life of the road network in this residential area.
Phase 1

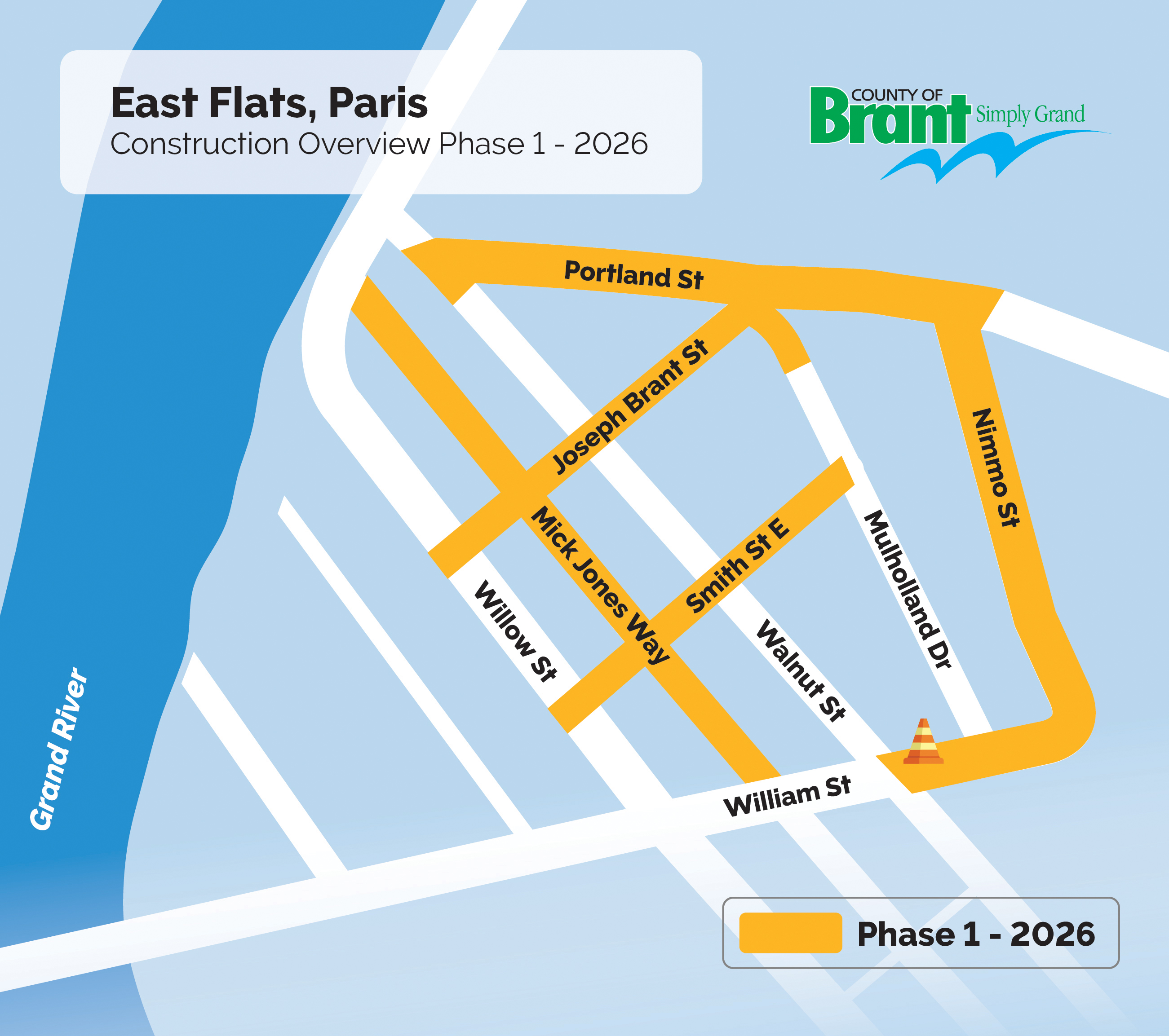

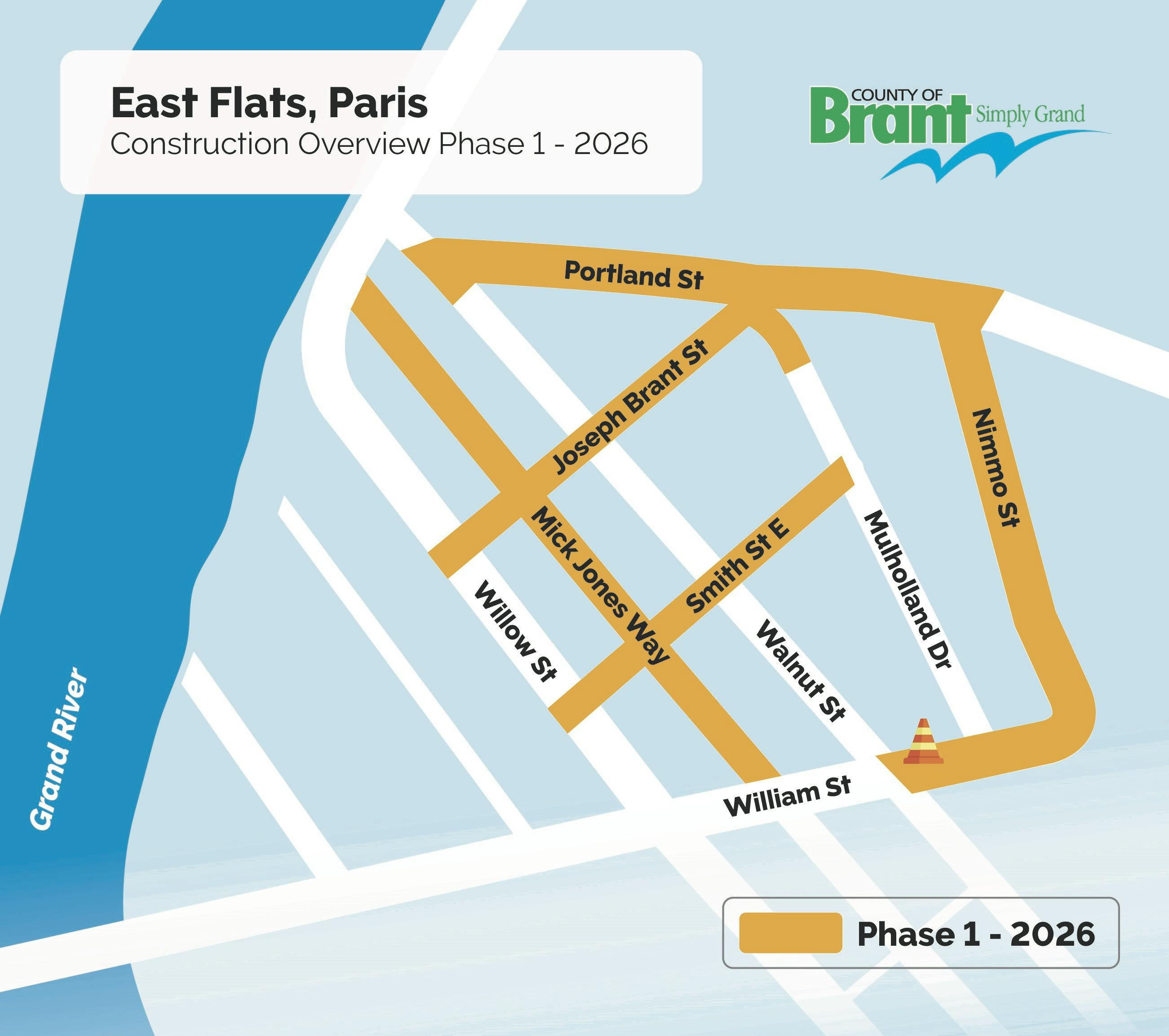

Construction timeline: Spring 2026 into late 2027
Phase 1 will include the full reconstruction of local residential streets on the east side of the Grand River (known as “The Flats”). It is important to note that no arterial roadsContinue reading
The County of Brant is planning road reconstruction work in the East Flats neighbourhood in Paris. This multi-year project will take place in 2 phases and will replace aging underground infrastructure and improve local roads.
The work will help ensure safe, reliable water service, improve stormwater management, and extend the life of the road network in this residential area.
Phase 1
Construction timeline: Spring 2026 into late 2027
Phase 1 will include the full reconstruction of local residential streets on the east side of the Grand River (known as “The Flats”). It is important to note that no arterial roads, such as Willow Street, are included in this phase.
| Work will include: | Streets include: |
|
|
During construction, local road closures and detours will be in place. Access for residents and emergency services will be maintained, and updates will be shared regularly.
Phase 2
Phase 2 is planned to include arterial streets such as Willow Street and is scheduled for spring 2028 and 2029. More information will be shared closer to that time.
Stay Informed
News feed: The Newsfeed is where you’ll find the latest updates about this project.
Subscribe for updates and be the first to get more information about this project! Simply add your email to the Stay Informed box on this page and click ‘Subscribe'.
-
May 2026: Construction notice
L82 (East) Construction Ltd. has been awarded the East Paris Flats Phase 1 Reconstruction project. The proposed works of Phase 1 will be completed in two phases (Phase 1: A and Phase 1: B) to minimize disruptions. Please see a map of the work area below. Impacts on properties are expected, including planned water shut-offs, excavation pits and limited parking. For the duration of the construction, affected properties will receive water from a temporary water supply system.

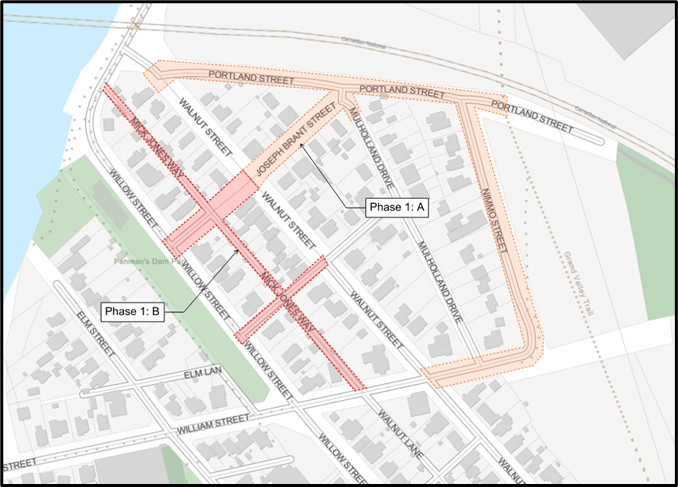

Phase 1: A
Includes but is not limited to:

- Installation of new watermain and water services
- Installation of new storm sewers
- Surface drainage improvements
- New concrete sidewalks
- Replacement of aging hard surfaces
Phase 1: B
Includes but is not limited to:
- Installation of new storm sewers
- Surface drainage improvements
- New concrete sidewalks
- Replacement of aging hard surfaces
When
- Construction is expected to begin on Monday, May 25, 2026
- Construction is expected to be completed on Friday, December 4, 2026

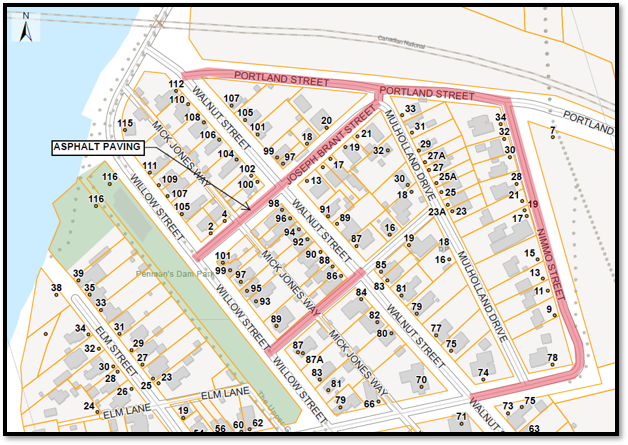

- Surface asphalt is anticipated to be completed before the end of the project, weather permitting, but may be pushed to the spring of 2027
During construction
Intersection impacts
During construction there will be impacts to intersections such as closures, flagging operations and delays. Residents must proceed with caution and follow any posted signage or detours.
Road or sidewalk impacts

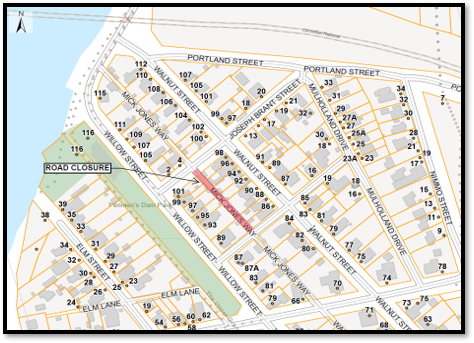

All roads under construction will be closed to through traffic. Accessibility will be maintained for local traffic and emergency access only. If local traffic cannot be maintained, further notification will be provided.
Noise/light
The allowable working hours for this project are 7:00 am to 7:00 pm, Monday to Friday. During construction, intermittent noise and vibration may occur from vacuum trucks, excavators, dump trucks, power generators, air compressors, paving equipment, concrete equipment, and other machinery. Dust is a natural part of the construction process. The contractor will be responsible for dust control. If dust is a concern, please contact to the onsite inspector.
Parking
Please refrain from parking on the street within the project limits during each phase of construction. Residents are encouraged to park in their driveways or in the designated parking areas outside the work zone. If street parking within the project limits is unavoidable, please ensure the vehicle is not located within the work zone during working hours, 7:00 am to 7:00 pm.
Access (private driveways, services or amenities)
Access to driveways will be maintained as much as possible throughout the duration of the project. Further notification will be provided when access to driveways will be affected.
Due to the nature of the work, municipal water will be shut off to properties for short durations. 48 hour notice will be provided prior to any water shut offs. When an emergency water shut off is required, residents may not receive advanced notice.
Utility service lines buried close to ground surface can be damaged or cut during construction. Residents who find their utility services have been disrupted should notify their phone or internet service provider immediately for repair.
Garbage
Materials are to be placed curbside before 7:00 am on the regular collection day. If required, the contractor will move bins to an appropriate location and return them in reasonable amount of time. Please ensure that your bins are clearly labelled with your address.
Right of way impacts
During construction, any privately owned infrastructure (irrigation: sprinklers, sprinkler heads/hose, etc.), landscaping (gardens, etc.), and decorations in the right of way may be damaged. Residents are responsible to relocate, remove and/or repair personal items that are in the right of way during construction. If any of the items listed above are relocated within the right of way and become damaged during construction, it is solely the resident’s responsibly to restore and/or repair. The County is only responsible for repairing driveways and lawns (topsoil and sod).
We're here for you
Have a question about this project? Let us know!
To receive project update emails directly to your inbox, add your email address to the 'Stay Informed' box on this page.
Please refer to Municipal511 www.municipal511.ca for the most up-to-date information regarding road construction and closures. It is our goal to minimize any inconvenience to our residents. Your patience through any disruption is greatly appreciated.
L82 (East) Construction Ltd. has been awarded the East Paris Flats Phase 1 Reconstruction project. The proposed works of Phase 1 will be completed in two phases (Phase 1: A and Phase 1: B) to minimize disruptions. Please see a map of the work area below. Impacts on properties are expected, including planned water shut-offs, excavation pits and limited parking. For the duration of the construction, affected properties will receive water from a temporary water supply system.
Phase 1: A
Includes but is not limited to:

- Installation of new watermain and water services
- Installation of new storm sewers
- Surface drainage improvements
- New concrete sidewalks
- Replacement of aging hard surfaces
Phase 1: B
Includes but is not limited to:
- Installation of new storm sewers
- Surface drainage improvements
- New concrete sidewalks
- Replacement of aging hard surfaces
When
- Construction is expected to begin on Monday, May 25, 2026
- Construction is expected to be completed on Friday, December 4, 2026
- Surface asphalt is anticipated to be completed before the end of the project, weather permitting, but may be pushed to the spring of 2027
During construction
Intersection impacts
During construction there will be impacts to intersections such as closures, flagging operations and delays. Residents must proceed with caution and follow any posted signage or detours.
Road or sidewalk impacts
All roads under construction will be closed to through traffic. Accessibility will be maintained for local traffic and emergency access only. If local traffic cannot be maintained, further notification will be provided.
Noise/light
The allowable working hours for this project are 7:00 am to 7:00 pm, Monday to Friday. During construction, intermittent noise and vibration may occur from vacuum trucks, excavators, dump trucks, power generators, air compressors, paving equipment, concrete equipment, and other machinery. Dust is a natural part of the construction process. The contractor will be responsible for dust control. If dust is a concern, please contact to the onsite inspector.
Parking
Please refrain from parking on the street within the project limits during each phase of construction. Residents are encouraged to park in their driveways or in the designated parking areas outside the work zone. If street parking within the project limits is unavoidable, please ensure the vehicle is not located within the work zone during working hours, 7:00 am to 7:00 pm.
Access (private driveways, services or amenities)
Access to driveways will be maintained as much as possible throughout the duration of the project. Further notification will be provided when access to driveways will be affected.
Due to the nature of the work, municipal water will be shut off to properties for short durations. 48 hour notice will be provided prior to any water shut offs. When an emergency water shut off is required, residents may not receive advanced notice.
Utility service lines buried close to ground surface can be damaged or cut during construction. Residents who find their utility services have been disrupted should notify their phone or internet service provider immediately for repair.
Garbage
Materials are to be placed curbside before 7:00 am on the regular collection day. If required, the contractor will move bins to an appropriate location and return them in reasonable amount of time. Please ensure that your bins are clearly labelled with your address.
Right of way impacts
During construction, any privately owned infrastructure (irrigation: sprinklers, sprinkler heads/hose, etc.), landscaping (gardens, etc.), and decorations in the right of way may be damaged. Residents are responsible to relocate, remove and/or repair personal items that are in the right of way during construction. If any of the items listed above are relocated within the right of way and become damaged during construction, it is solely the resident’s responsibly to restore and/or repair. The County is only responsible for repairing driveways and lawns (topsoil and sod).
We're here for you
Have a question about this project? Let us know!
To receive project update emails directly to your inbox, add your email address to the 'Stay Informed' box on this page.
Please refer to Municipal511 www.municipal511.ca for the most up-to-date information regarding road construction and closures. It is our goal to minimize any inconvenience to our residents. Your patience through any disruption is greatly appreciated.
-
April 2026 - Updated construction timeline
The construction schedule for the East Flats Reconstruction project has been updated. Phase 1 construction is now anticipated to begin in Summer 2026 with completion now anticipated in late 2027.
As you know, large infrastructure projects require careful planning, coordination, and scheduling. Adjusting the construction timeline helps ensure the work can be completed safely and efficiently while minimizing impacts to residents. We appreciate your patience and understanding.
What’s Next
As the project moves closer to construction, additional information will be shared about timing, traffic impacts, detours, and property access. Updates will continue to be posted on this page as newContinue reading
The construction schedule for the East Flats Reconstruction project has been updated. Phase 1 construction is now anticipated to begin in Summer 2026 with completion now anticipated in late 2027.
As you know, large infrastructure projects require careful planning, coordination, and scheduling. Adjusting the construction timeline helps ensure the work can be completed safely and efficiently while minimizing impacts to residents. We appreciate your patience and understanding.
What’s Next
As the project moves closer to construction, additional information will be shared about timing, traffic impacts, detours, and property access. Updates will continue to be posted on this page as new details become available.
We encourage you to subscribe to this project page to receive future updates as construction planning progresses. Subscribe for updates by adding your email to the "Stay Informed" box on this page and click “Subscribe.”
-
Thank you for your feedback! - An update on what we heard and what's next
Thank you to the residents who attended the November 24 Open House and to those who shared feedback online between November 11, 2025, to January 31, 2026. Your input helps staff better understand how construction will affect daily life in this neighbourhood.
The focus of this engagement was to identify driveway access needs, parking and mobility considerations, and any other special requirements such as accessibility, deliveries, or property protection in the East Flats neighbourhood of Paris.
A quick look at participation:
- 331 visits to the Engage project page
- 16 feedback forms submitted
- 8 additional questions or comments received
- 40 residentsContinue reading
Thank you to the residents who attended the November 24 Open House and to those who shared feedback online between November 11, 2025, to January 31, 2026. Your input helps staff better understand how construction will affect daily life in this neighbourhood.
The focus of this engagement was to identify driveway access needs, parking and mobility considerations, and any other special requirements such as accessibility, deliveries, or property protection in the East Flats neighbourhood of Paris.
A quick look at participation:
- 331 visits to the Engage project page
- 16 feedback forms submitted
- 8 additional questions or comments received
- 40 residents attended the November 24 Open House
Here is a brief summary of what we heard:
- Clear and early communication about driveway closures and timelines are requested
- Due to limited space, a plan for temporary parking is needed
- Assurance that mature trees and private property will be protected
- Support for residents with mobility or health related needs is important
- Safe access for children walking to school and for delivery and service vehicles is required
What’s next
Staff will incorporate the feedback we received into construction planning and post maps and other construction materials before the project begins this summer.
We will work directly with residents who identified unique accessibility or property concerns and continue to share updates on this page as timelines are confirmed to reduce disruption and address concerns quickly.
We encourage you to please subscribe for East Flats construction updates by adding your email to the Stay Informed box on this page and click ‘Subscribe'.
-
Learn more and share your feedback about the East Flats road construction project
We want to hear from residents of the East Flats neighbourhood as we prepare for this important infrastructure project.
Attend the Open House
Join us at an in-person Open House to learn more about the project, speak with County staff, and share your input.
Monday, November 24, 2025
County of Brant Council Chambers, 7 Broadway Street, West in Paris
6:00 pm to 8:00 pm
You’ll have an opportunity to:
- View the preliminary project plans
- Ask questions about construction timing and impacts
- Discuss specific needs related to your property or driveway
This will be a drop-in open house. Though no formalContinue reading
We want to hear from residents of the East Flats neighbourhood as we prepare for this important infrastructure project.
Attend the Open House
Join us at an in-person Open House to learn more about the project, speak with County staff, and share your input.
Monday, November 24, 2025
County of Brant Council Chambers, 7 Broadway Street, West in Paris
6:00 pm to 8:00 pm
You’ll have an opportunity to:
- View the preliminary project plans
- Ask questions about construction timing and impacts
- Discuss specific needs related to your property or driveway
This will be a drop-in open house. Though no formal presentation will be provided, design drawings will be available to view. County of Brant staff will be hand delivering notices to the neighbourhood residents outlined above on November 10 and 11, 2025.
Can’t attend in person?
If you can’t make it to the Open House, don't worry! You can still share your feedback online.
Please complete the East Flats Feedback Form to let us know about any specific needs, requests, or concerns related to your property or driveway.
Feedback is open until January 31, 2026.
Questions or comments
Have a question or comment about the project? Let us know!
Why your input matters
Your feedback will help County staff better understand any specific needs, requests, or concerns related to:
- Your driveway access
- Parking or mobility needs during construction
- Any other special considerations (for example, accessibility or deliveries)
Project timeline
-
Phase 1: May 2026 Construction begins
East Flats, Paris is currently at this stageWork will include the full reconstruction of local residential streets on the east side of the Grand River. No arterial roads, such as Willow Street, are included in this phase.
-
Late 2027: Anticipated completion of Phase 1
this is an upcoming stage for East Flats, ParisMore information will be provided as construction continues into 2026.
-
Phase 2: Spring 2028 construction expected to take place
this is an upcoming stage for East Flats, ParisMore information will be shared closer to that time.
Follow Project
Key Dates
-
November 10 2025 → January 31 2026
-
November 24 2025
Who's Listening
-
Phone 519-44BRANT (519-442-7268) Email mark.maxwell@brant.ca -
Phone 519-44BRANT (519-442-7268) Email clint.brown@brant.ca
